Manufacturing Process

At Sunset Sleepers, our concrete sleeper manufacturing process ensures precision, durability, and high-quality concrete sleepers for retaining wall structures.

Step 1. Mould Creation

The foundation of a superior concrete sleeper begins with a high-quality mould.

We manufacture all of our our concrete sleeper moulds in-house using specially selected steel.

The steel is cut, bent, and welded with a slight taper (5-7mm at the ends from face to back of sleeper at the ends) to allow for easy de-molding without damaging the sleepers.

A Sunset Sleepers Plant Worker Developing a Mould for Concrete Sleepers
A Sunset Sleepers Plant Worker Developing a Mould for Concrete Sleepers

Step 2. Mould Cleaning

After each production cycle, every concrete sleeper mould undergoes a thorough cleaning process.

Depending on the condition of the mould, cleaning may involve:

  • Simple vacuuming and wiping with a cloth.
  • Using steel wool for moderate dirt.
  • A steel brush is employed for heavier debris.
  •
Cleaning Concrete Sleeper Moulds Before Application of Release Agent
Cleaning Concrete Sleeper Moulds Before Application of Release Agent

Step 3. Application of Release Agent

A special release agent spray is applied to the clean concrete sleeper mould to ensure the concrete sleeper does not stick during the de-molding process.

A thin, even coat of the agent is applied, similar to greasing a baking tray, and is left to settle.

  •

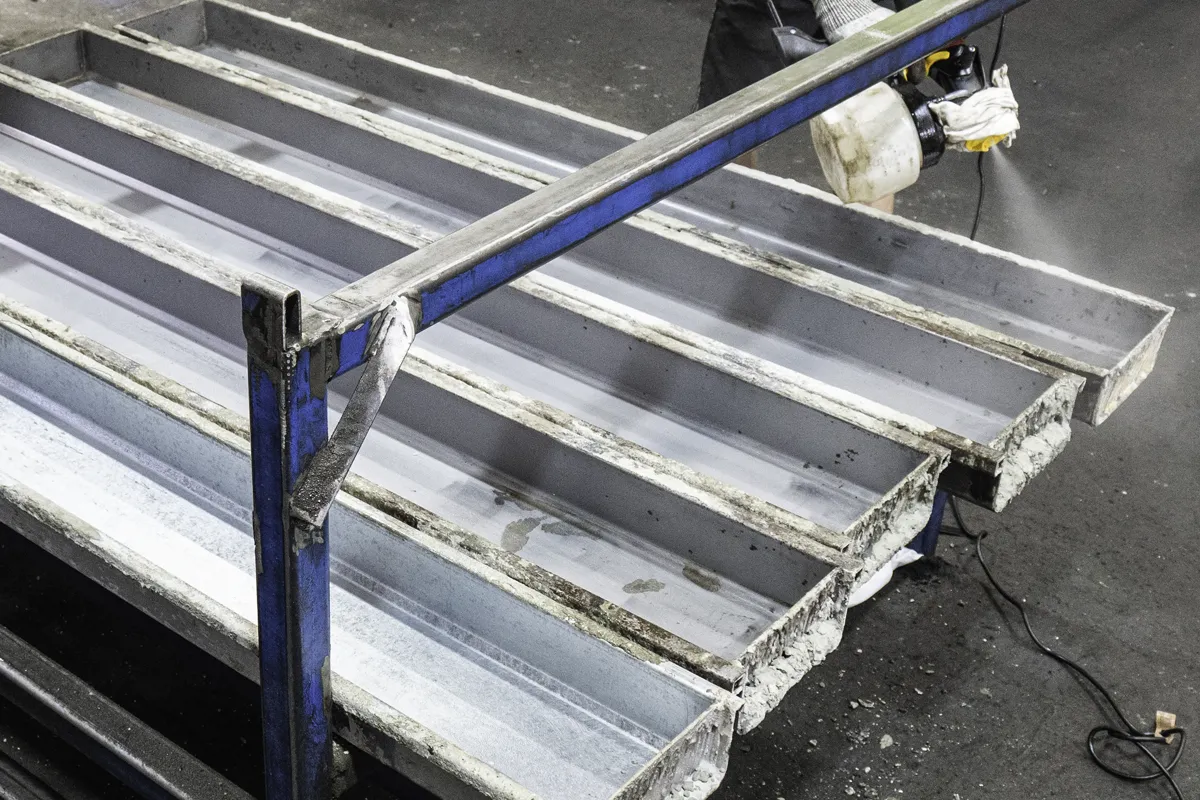

Application of Release Agent on Concrete Sleeper Moulds for Easy De Moulding Process
Application of Release Agent on Concrete Sleeper Moulds for Easy De Moulding Process

Step 4. Reinforcement Placement

All our concrete sleepers are reinforced using 2x N12 REO Bars as Standard to for superior strength, durability and resistance to cracking.

Depending on the sleeper width and length, 3x N12 reinforcement bars are used, although we can custom manufacture all of our concrete sleeper sizes in 3x N12 if required by the customer..

Purpose-built reinforcement bar holders (or “chairs”) are used to secure the bars in the correct position.

Placing REO Bars in Concrete Sleeper Moulds
Placing REO Bars in Concrete Sleeper Moulds

Step 5. Concrete Pouring and Vibrating

The concrete sleeper moulds are then filled with a specially engineered Boral® concrete mix rated at a minimum of 40 MPa.

The concrete sleeper mould are then vibrated to eliminate any air bubbles and ensure a dense, uniform concrete sleeper.

For concrete sleepers requiring custom colour, oxide pigments are added to the concrete mix prior to pouring to achieve a consistent, vibrant finish.

Concrete Pouring into Concrete Sleeper Moulds
Concrete Pouring into Concrete Sleeper Moulds

Step 6. Curing

The concrete sleepers are left to cure overnight in the moulds for the following day.

In colder weather, we may apply additional heat to aid the curing process.

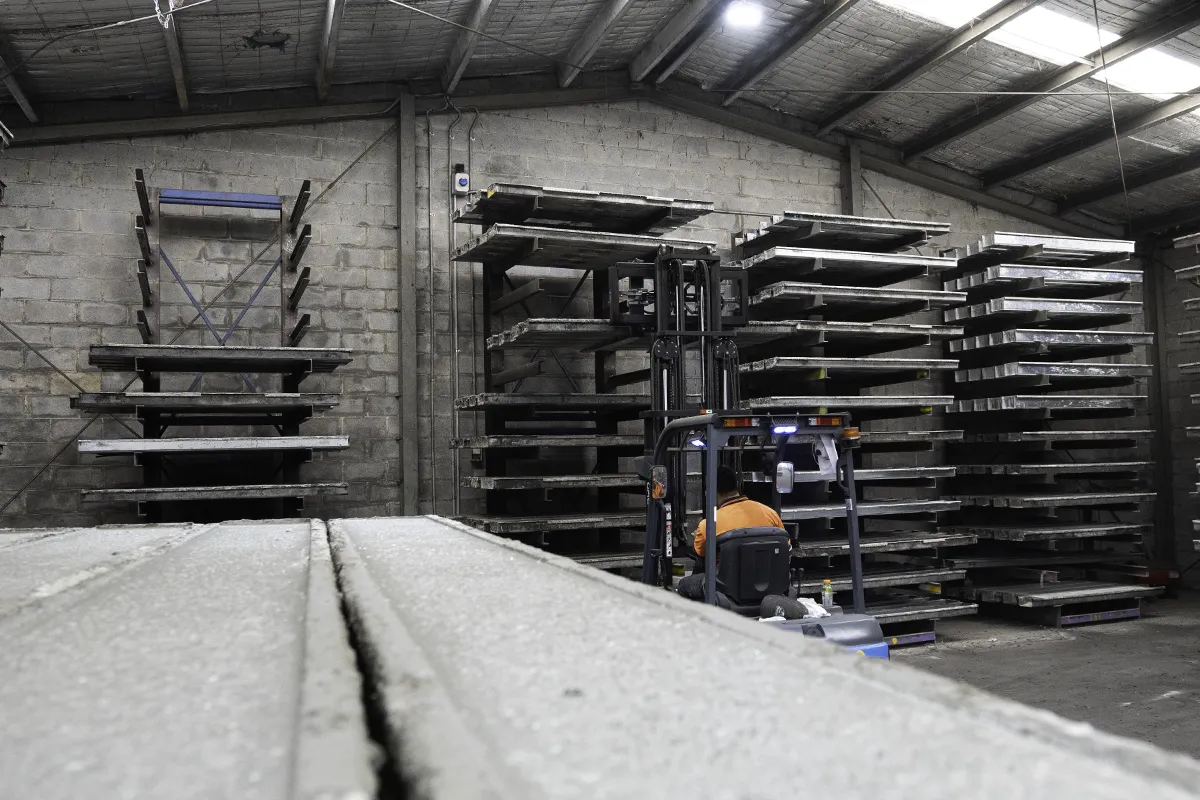

Curing Process of Concrete Sleepers
Curing Process of Concrete Sleepers

Step 7. De-molding Process

Once the concrete sleepers have cured overnight, the moulds are then passed through a conveyor system to de-mould the concrete sleepers efficiently and without damaging them.

Concrete Sleepers De moulding Process
Concrete Sleepers De-moulding Process

Step 8. Quality Assurance

Each concrete sleeper then undergoes rigorous quality checks to meet our high standards.

Any defective concrete sleepers are either recycled or sold separately as seconds.

Concrete Sleepers Quality Assurance Checks
Concrete Sleepers Quality Assurance Checks

Step 9. Production Date and Custom Markings

Once quality assurance tests are passed, each concrete sleepers is then stamped with its production date and any specific requirements such as unique barcodes to ensure traceability and compliance.

Custom Barcodes and Production Dates on Concrete Sleepers
Custom Barcodes and Production Dates on Concrete Sleepers

Step 10. Strapping and Packing

Finished concrete sleepers are then packed on timber bearers in bundles of 8 or 10, depending on their depth.

Strapping Concrete Sleepers in Packs of 8 or 10
Strapping Concrete Sleepers in Packs of 8 or 10

Step 11. Storage & Further Curing

Forklifts then come pick up the strapped sleepers and store them in our yard for additional curing until they are ready for pickup or delivery for the customer.

Concrete Sleepers are stored in our yards to futher cure before being picked up or delivered to the customer
Concrete Sleepers are stored in our yards to futher cure before being picked up or delivered to the customer
